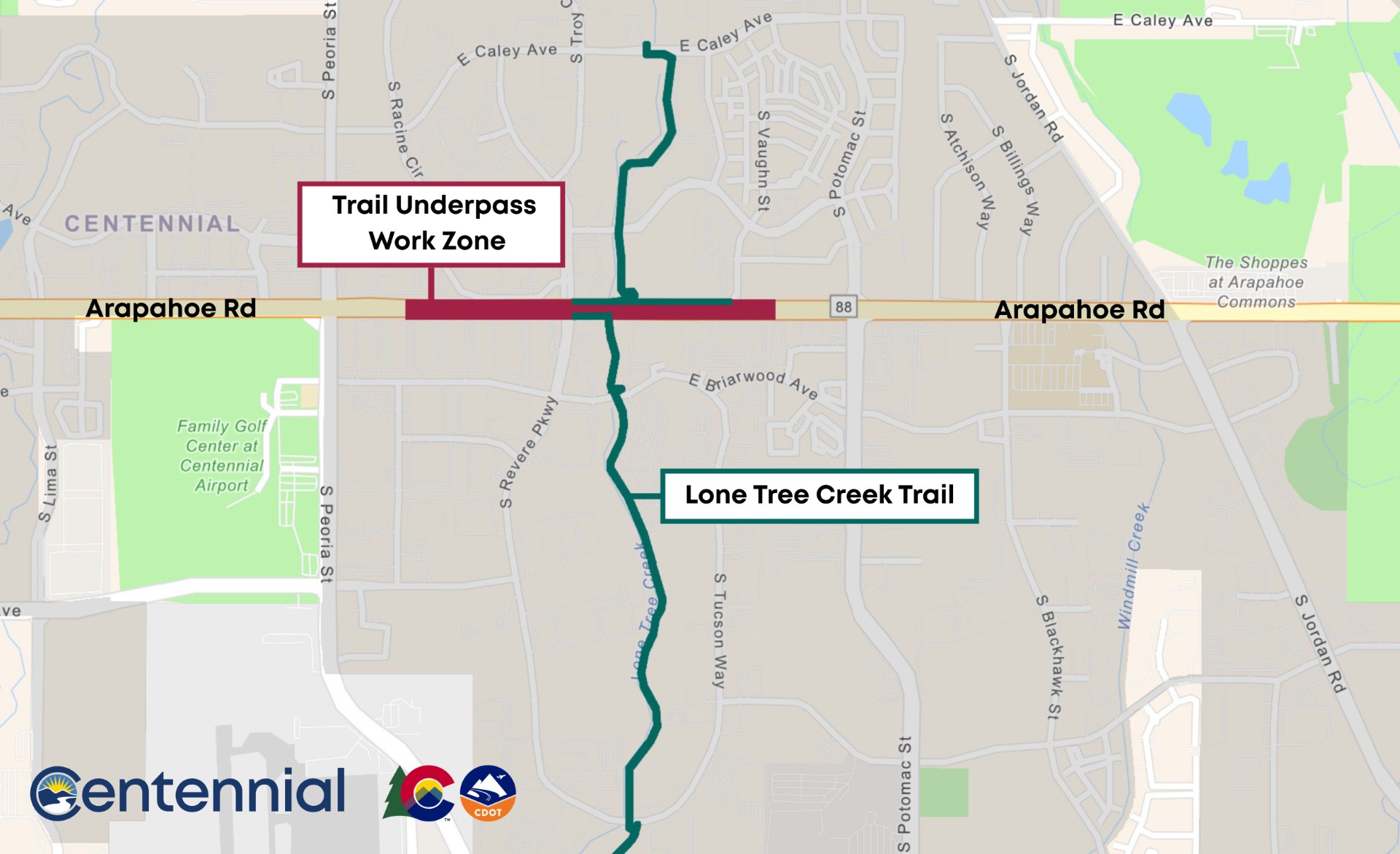

Lone Tree Creek Trail Underpass at Arapahoe Rd.
Overview
The City of Centennial is constructing a new dedicated underpass to improve trail connectivity and safety along the Lone Tree Creek Trail corridor at E. Arapahoe Rd. between S. Revere Pkwy. and S. Potomac St. The project includes construction of a concrete box culvert under E. Arapahoe Rd., which will be dedicated to bicyclists and pedestrians. It will allow trail users to travel beneath the roadway separate from vehicular traffic and eliminate the need to cross traffic at the existing S. Revere Pkwy. crosswalk.
Project Location: E. Arapahoe Rd. between S. Revere Pkwy. and S. Potomac St.
Project Timeline: Construction began April 2026 and ends early Spring 2027.
Traffic Impacts
E. Arapahoe Rd. Traffic Impacts
Three lanes of traffic will remain open in both directions of E. Arapahoe Rd. during peak travel hours. Motorists can expect intermittent single and double-lane closures on E. Arapahoe Rd. during the following off-peak travel hours:
Eastbound E. Arapahoe Rd.
Monday - Friday, 9 a.m. to 3 p.m.
Westbound E. Arapahoe Rd.
Monday - Friday, 10 a.m. to 3 p.m.
Sidewalk closures along both directions of E. Arapahoe Rd. will occur at different times depending on the construction phase (see project phasing below) with a signed detour in place.
Nighttime and weekend work will be limited. During overnight operations, drivers can expect single and double-lane closures in each direction from Sunday night through Friday morning, 6 p.m. to 5 a.m.
E. Arapahoe Rd. and Revere Pkwy. Traffic Impacts

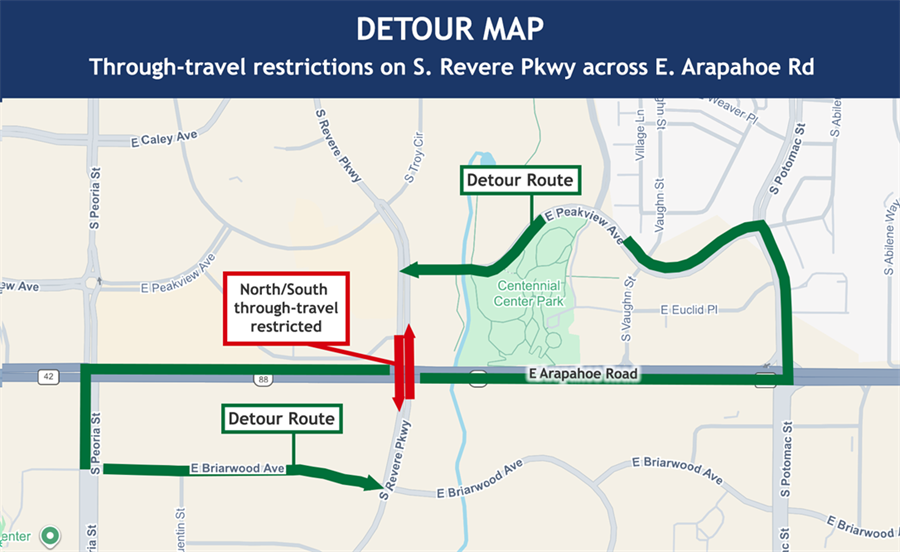

For the duration of the project, all left turn movements at the intersection of E. Arapahoe Rd. and Revere Pkwy. will be restricted, and motorists cannot proceed straight on Revere Pkwy. across Arapahoe Rd. Only right turn movements will be maintained during construction at this intersection.
Motorists are encouraged to use S. Peoria St. and S. Potomac St. as alternate travel routes.
Project Phasing
Construction will be completed in three phases with traffic shifts on E. Arapahoe Rd. to allow crews to safely work behind Temporary Concrete Barriers. Dates are weather dependent and subject to change.
Phase I – April - July 2026
- E. Arapahoe Rd. traffic will shift to the south. The sidewalk along westbound E. Arapahoe Rd. will be closed with a signed detour route.
- Construction on the north side of E. Arapahoe Rd.: Work includes extending the existing culvert that carries Lone Tree Creek and beginning construction of the new concrete box culvert under westbound E. Arapahoe Rd., along with associated walls.
Phase II – August - September 2026
- Traffic will be shifted to the outside of eastbound and westbound E. Arapahoe Rd. The sidewalk along both directions of E. Arapahoe Rd. will remain open.
- Construction in the middle of E. Arapahoe Rd.: Work includes continued construction of the new culvert under the left turn lanes on westbound E. Arapahoe Rd.
Phase III – October - early Spring 2027
- E. Arapahoe Rd. traffic will be shifted to the north. The sidewalk along eastbound E. Arapahoe Rd. will be closed with a signed detour route.
- Construction on the south side of E. Arapahoe Rd.: Crews will complete the new concrete box culvert and connect the underpass to sidewalks/trail connections, and finish sidewalk work.
Project Benefits
Upon completion, the project will provide a dedicated underpass for bicyclists and pedestrians, improving safety and connectivity for Lone Tree Creek Trail users across E. Arapahoe Rd.
Questions
Email the project team at lonetreetrailunderpass@gmail.com or call the project team at 720-656–5724 for questions.
Sign up for email alerts here.
Please continue to check this page for project updates.
